Update on construction progress : Since July until November 2024, this project is progressing at a rapid pace . In order for customers to get regular updates on the project progress , we will regularly update the construction progress on this website.
Actual Site Construction Progress

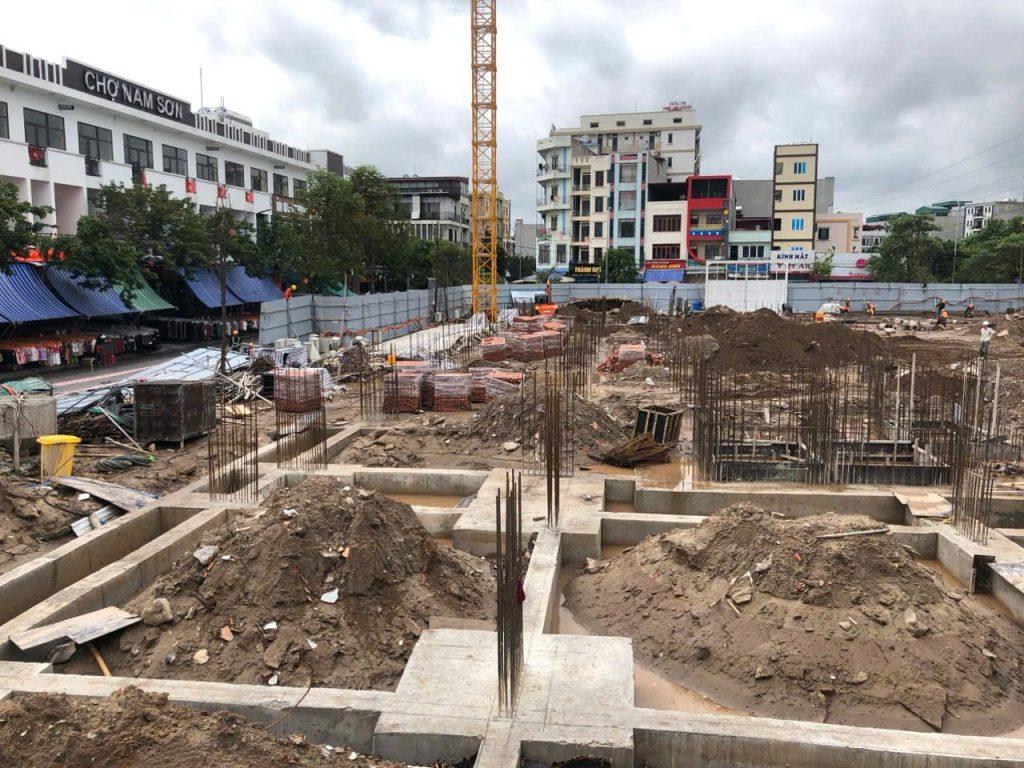

As soon as Redamco obtained its construction license and the relevant approvals from Bacninh DOC to start construction, Redamco main contractor Licogi13 FC, immediately started to mobilise its resources and started site preparations on 11July24 . Since then it has achieved the following rapid progress :

Project site levelled and piling started – Photo taken on July 11, 2024

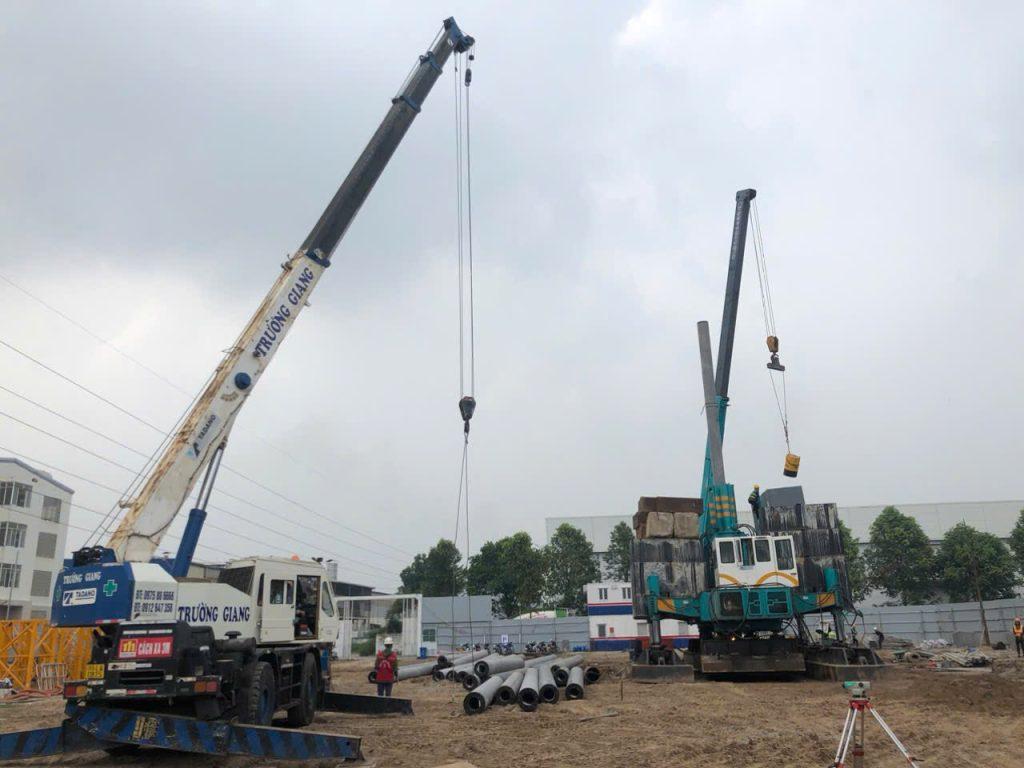

Piling foundation – Photo taken on July 18, 2024

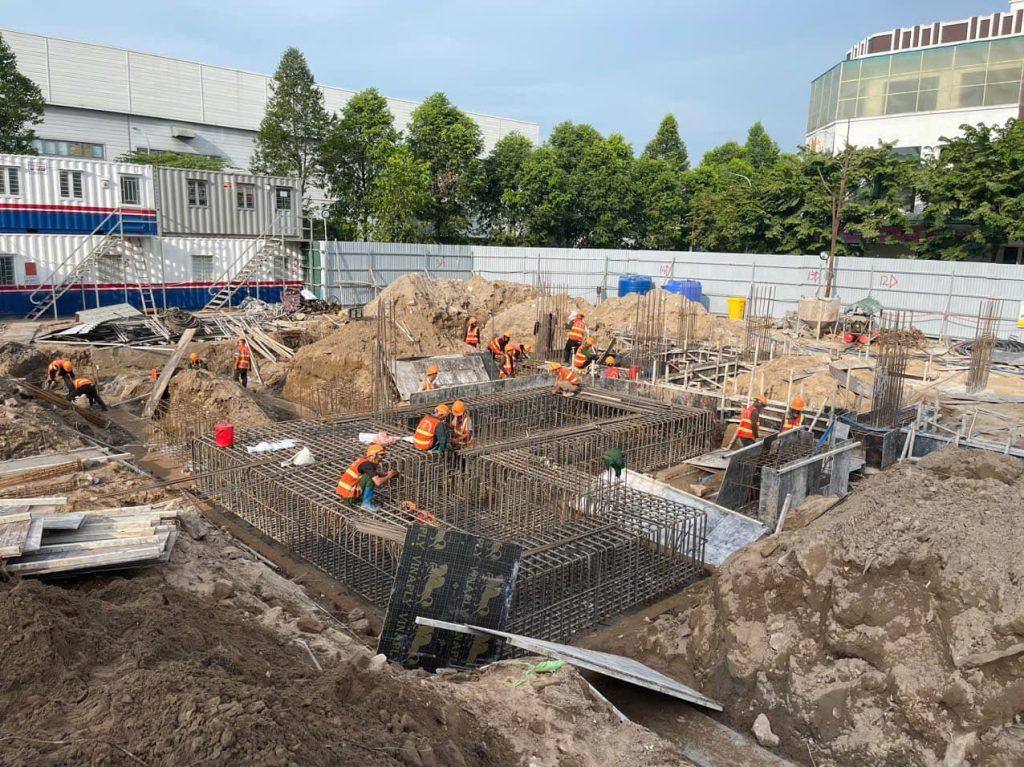

Continue project foundation – Photo taken on July 25, 2024

Construction supervision – Photo taken on August 10, 2024

Construction quality is top priority – Photo taken on August 18, 2024

Work still continue during holidays – Photo taken on September 2, 2024

Pouring concrete for construction foundation – Photo taken on September 4, 2024

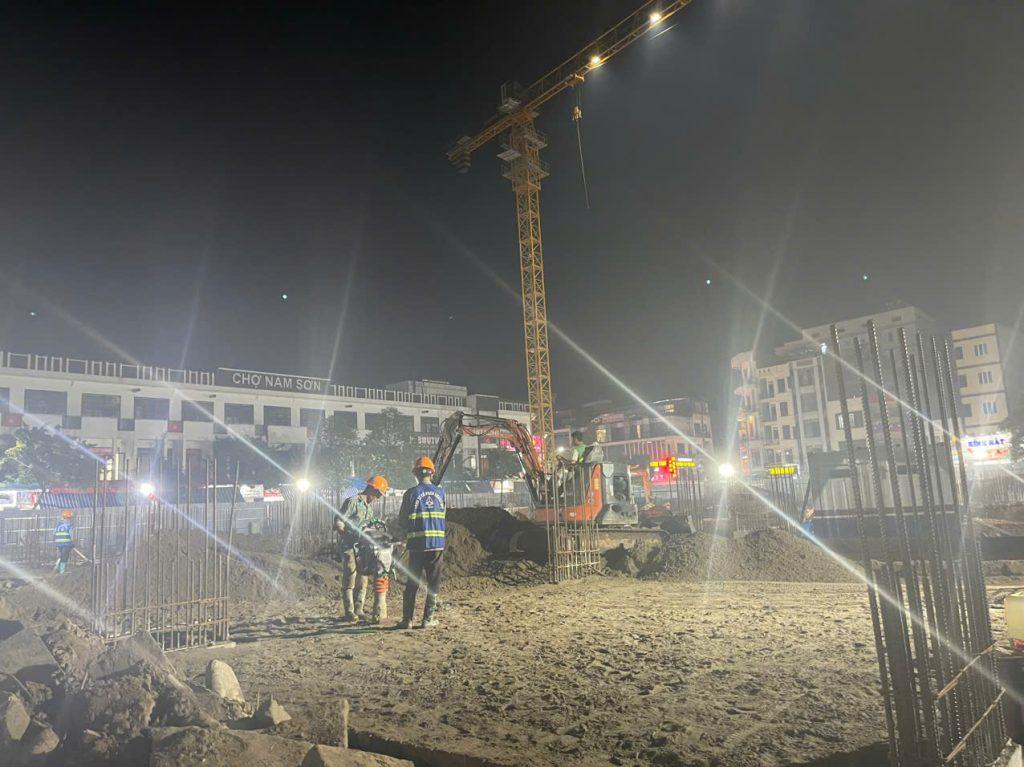

Work 3 shifts to catch up delay due to Typhoon Yagi – Photo taken on September 19, 2024

Site Safety is also top priority : Site occupational safety training – Photo taken on September 20, 2024

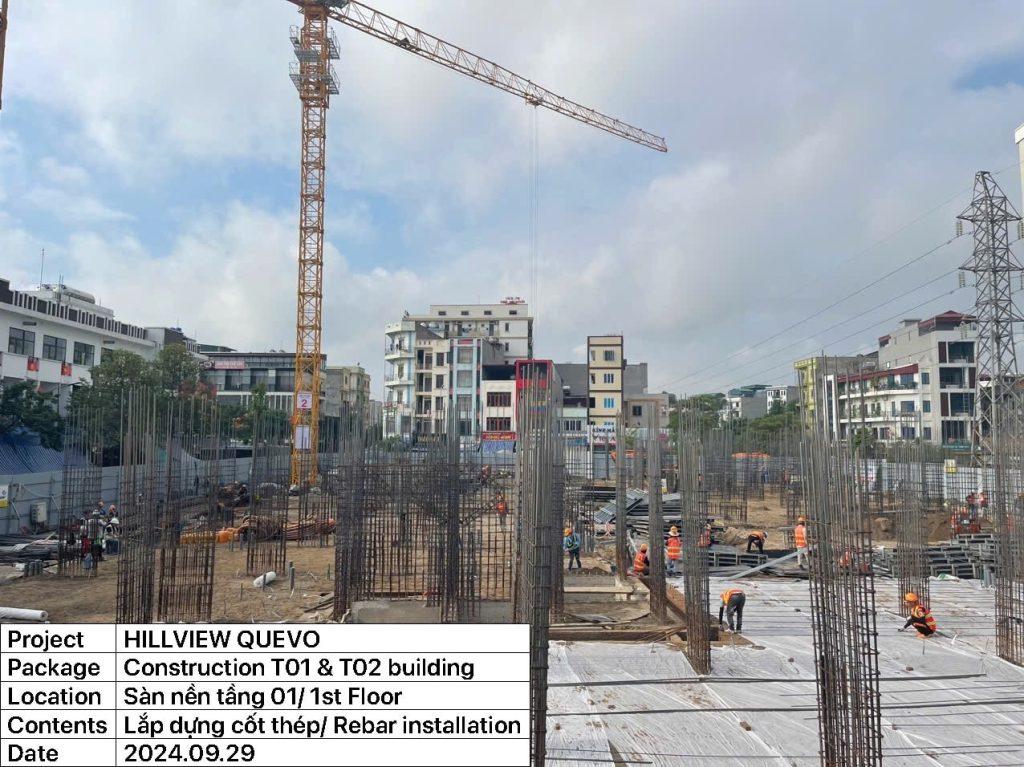

Installing steel reinforcement for the first floor of the project – Photo taken on September 29, 2024

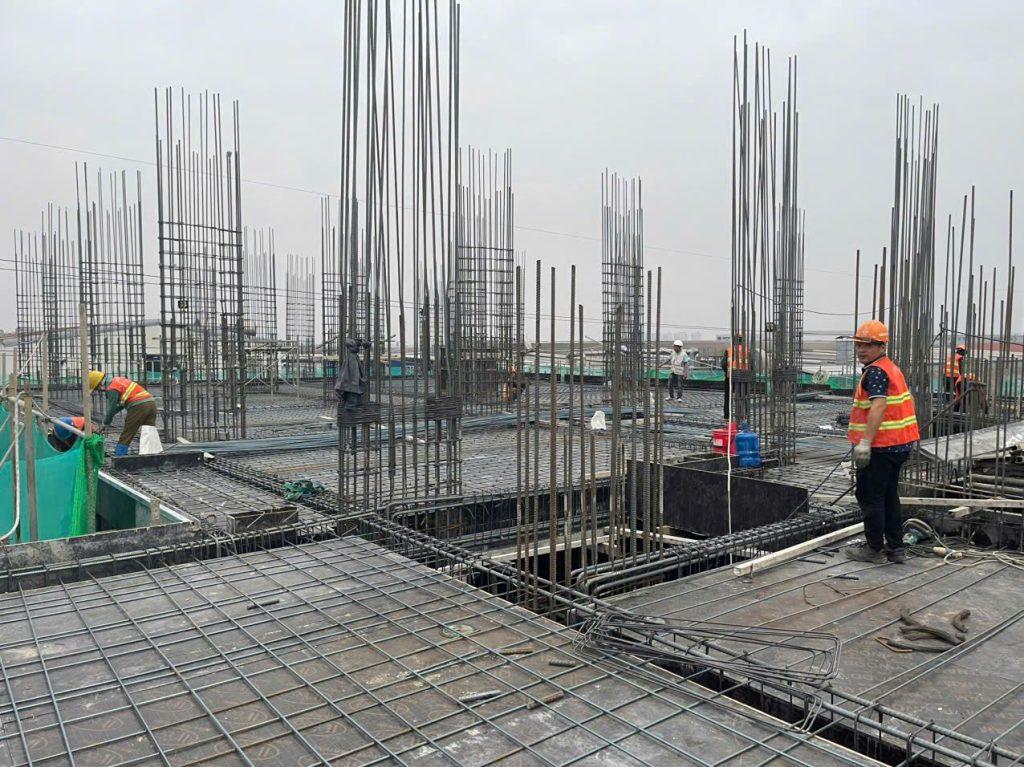

Completed concrete on the first floor – Photo taken on October 2, 2024

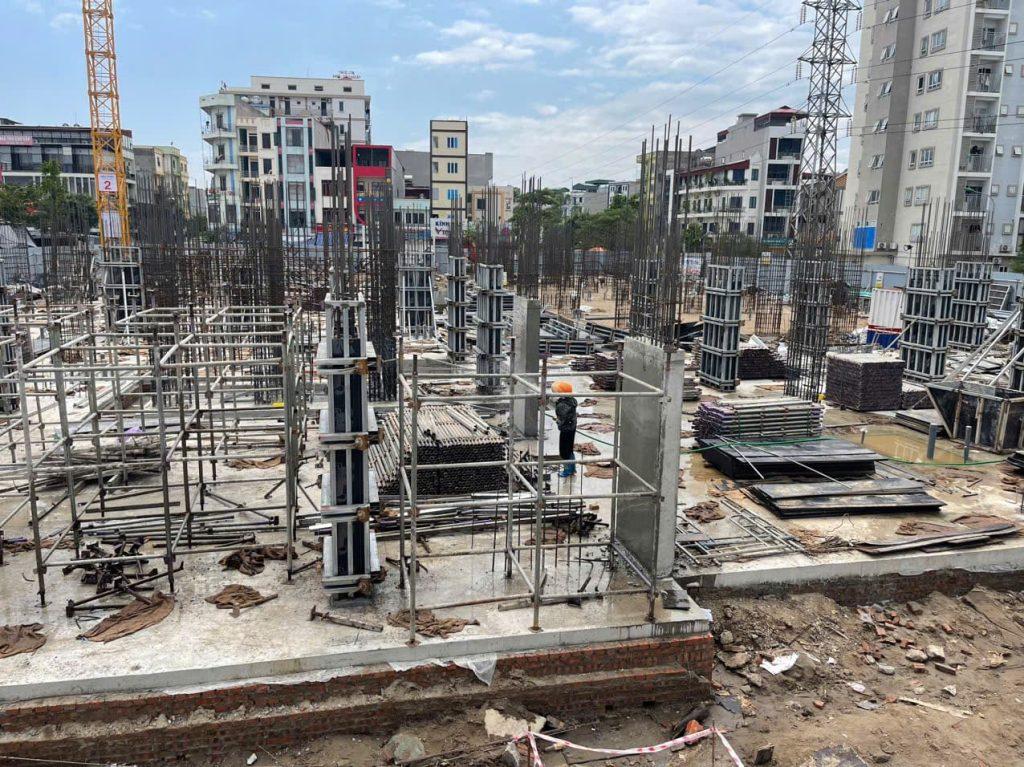

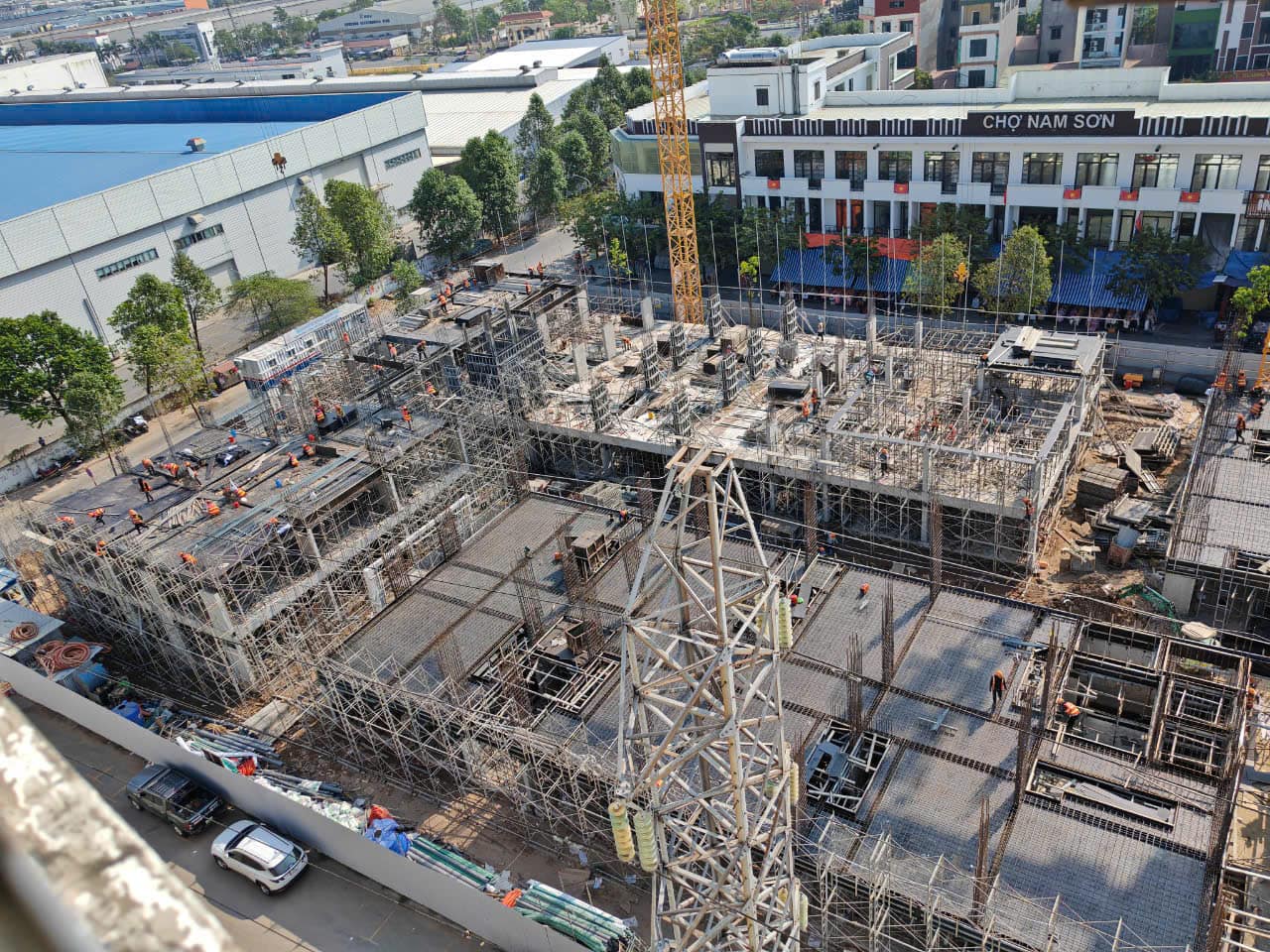

First floor Column formwork installation – Photo taken on October 3, 2024

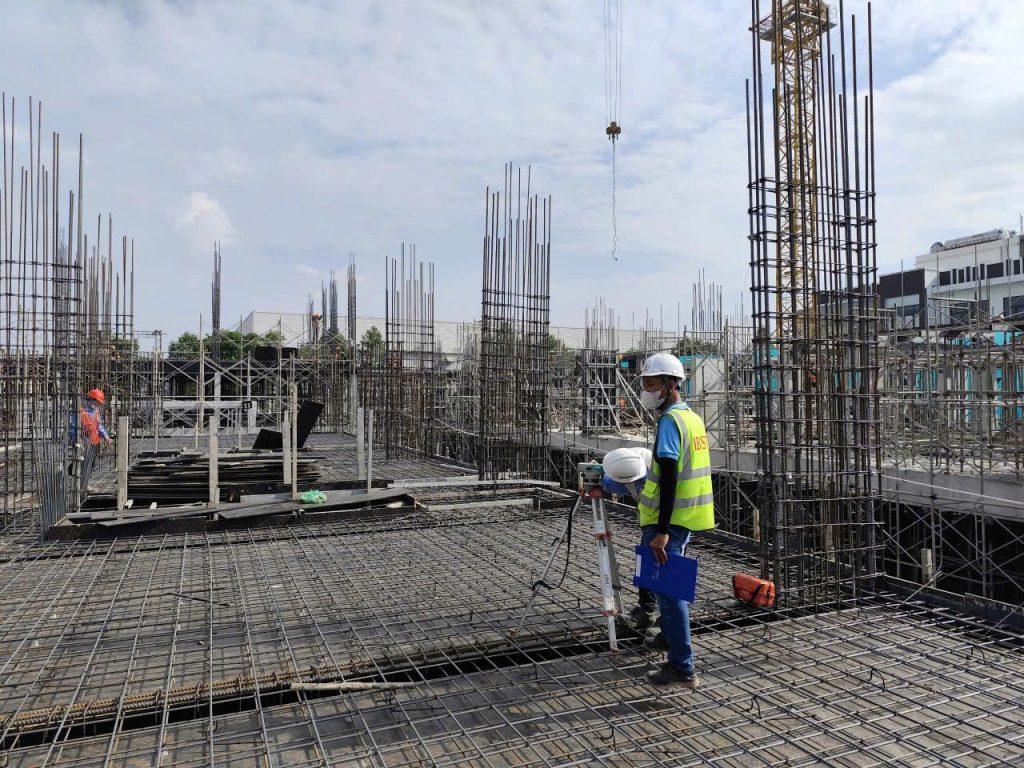

Start Construction of the T1 3rd floor of the project – Photo taken on October 14, 2024

Construction of formwork and reinforcement of 4th floor beams – Photo taken on October 26, 2024

Construction of concrete pouring for 5th floor – Photo taken on November 09, 2024

Topping out ceremony of buildings T1 & T2 of Que Vo Hillview project – Photo taken on January 07, 2025

Investor Redamco takes a photo with the contractor at the topping out ceremony – Photo taken on January 07, 2025

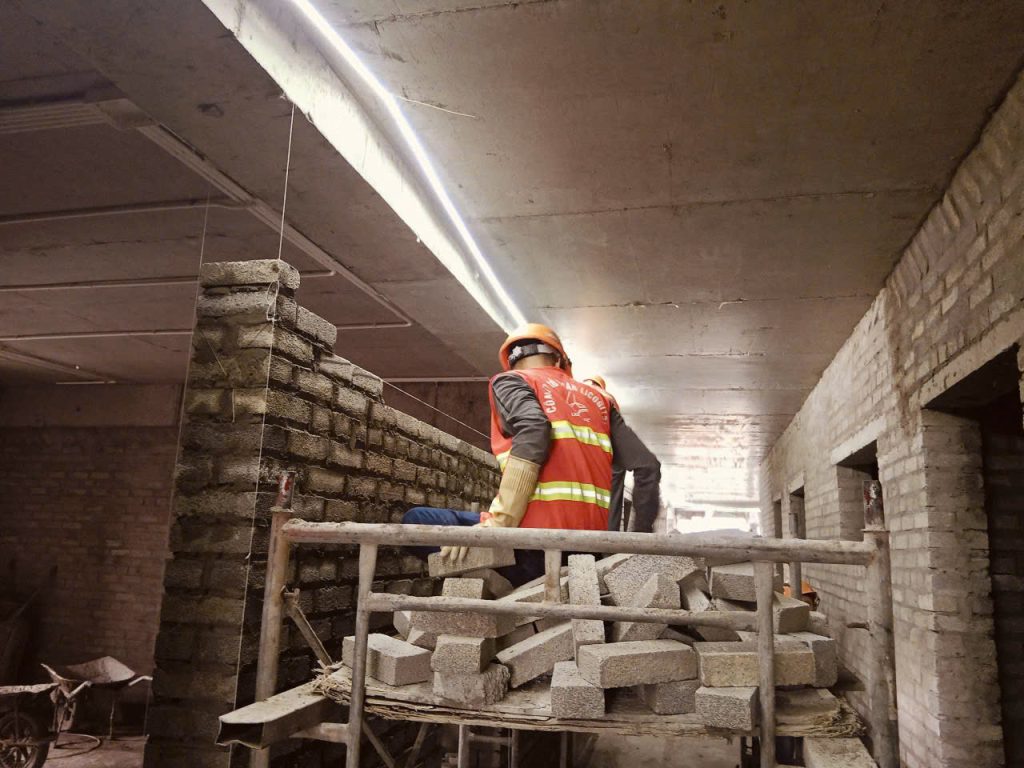

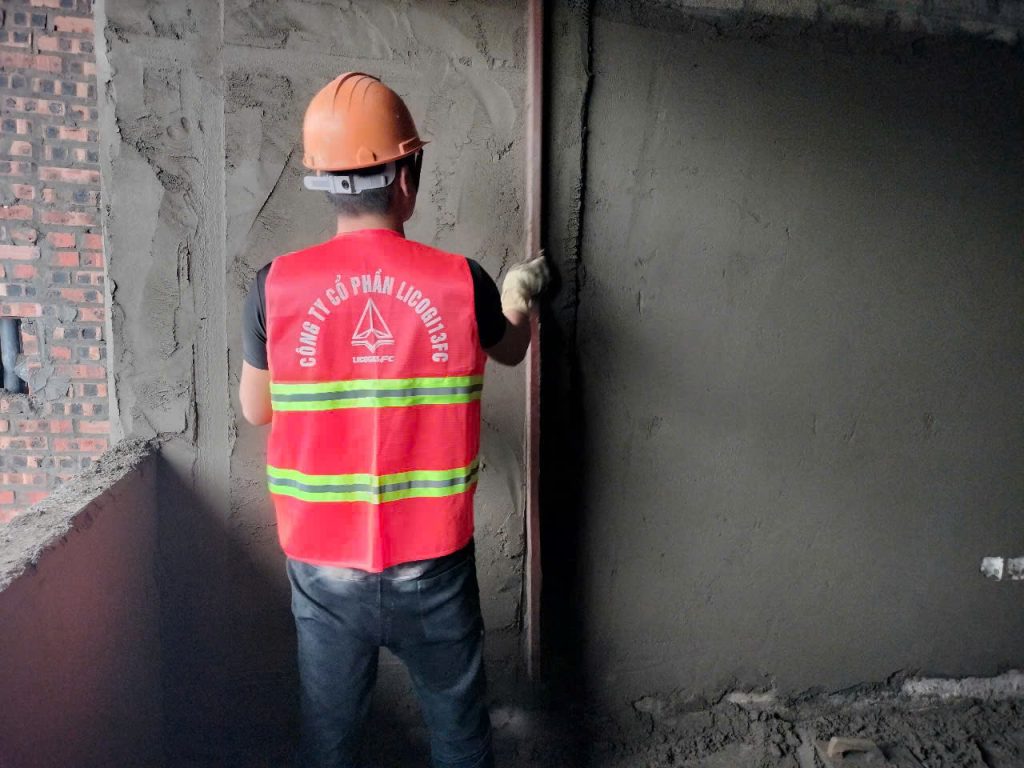

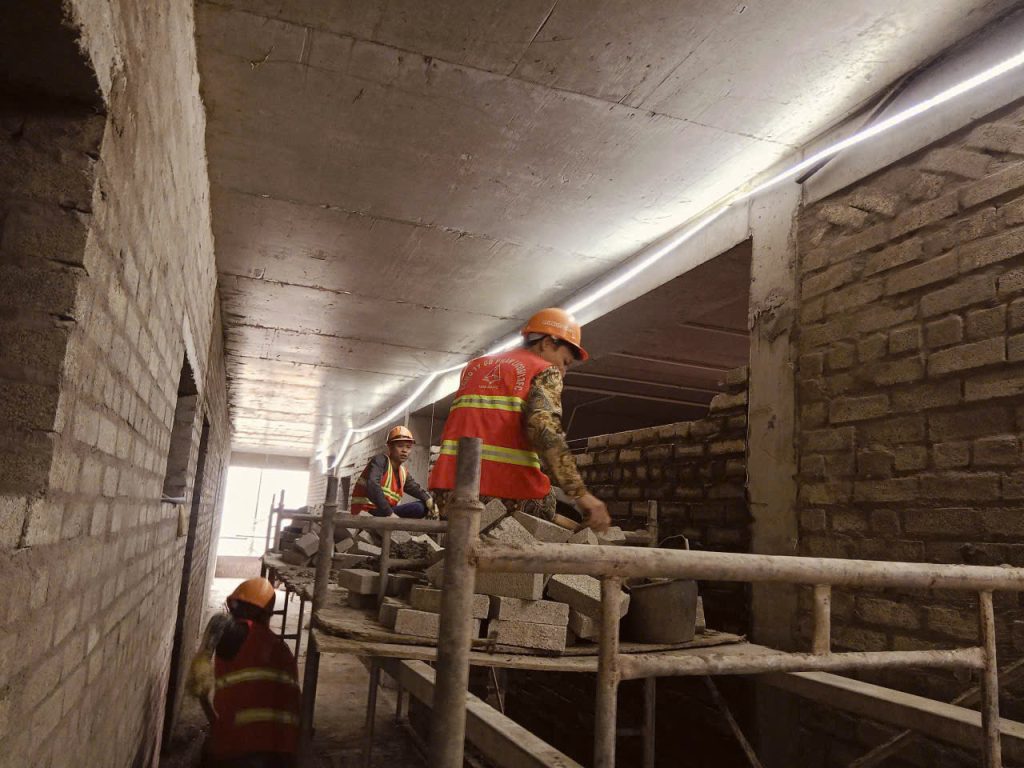

Internal brick walls and plastering in progress – Photo taken on February 17, 2025

Interior progress of T1 building – Photo taken on February 17, 2025

Internal brick walls T2 building – Photo taken on February 17, 2025
